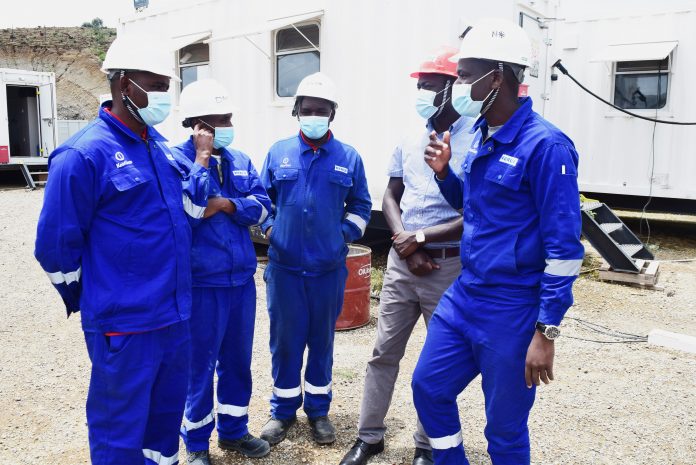

Kenya Electricity Generating Company PLC (KenGen) has surpassed a crucial stage in the ongoing USD 6.2 million geothermal drilling contract in Ethiopia further giving impetus to its corporate diversification strategy.
The team of KenGen engineers have so far crossed the 450 meters of drilling depth of the first of eight geothermal wells for the state-owned electricity producer, Ethiopia Electric Power Company which commenced in May this year amid COVID-19.
“The first 450 meters is the most difficult phase of the entire geothermal well drilling process which can go upto a depth of 3,000 meters,” said Managing Director and CEO, Rebecca Miano adding, “this particular one is being done under peculiar circumstances including unforeseen delays occasioned by the COVID-19 pandemic.”
“We will be drilling at a rate of about 50 meters per day going forward and therefore expect to complete the remaining part on schedule in about two months,” said Mrs. Miano.
In February 2019, KenGen won a joint contract with Shandong Kerui Petroleum Equipment Company and Shandong Kerui Oilfield Service Group to offer geothermal drilling services. The project is being managed between the two consortium members under the contract.
READ>>>>>KenGen To Benefit From Climate Action Carbon Credits
“We are glad that the progress of drilling at Aluto-Langano is remarkable, and optimistic our team will deliver it within the set timelines. We commend our team for surpassing the 450 metres depth of drilling, overcoming all the challenges usually encountered at the initial stages of drilling a geothermal well,” said Miano.
She added: “We have a team of experts comprised of aerated drillers, directional drillers, and reservoir engineers actively working on this project and have also dispatched a team to mobilize a second rig to fast track the process and achieve our goal of drilling eight wells much faster.”
The drilling of the second geothermal well under the Aluto-Langano project started early this week and was at a depth of 36 meters by Wednesday August 18, 2021.
KenGen is hopeful that under the ongoing project, which is financed by the World Bank through a loan to the Ethiopian Government, depending on the outcomes of Lot 1 wells, an additional 12 wells may be drilled under Lot 2 of the contact to bring the total to 20 wells.
At the same time, also in the Horn of Africa, under a contract signed in October 2019, KenGen has completed drilling two geothermal wells for Tulu Moye Geothermal Operations PLC (TMGO) in Ethiopia and is currently drilling the third well.
These two projects are hinged on the Company’s diversification strategy which has led to the organization’s expansion in the Horn of Africa. Besides Ethiopia, KenGen has also secured a Ksh.709 million project to offer commercial drilling services in Djibouti.
In February this year, the company signed the contract with Office Djiboutien De Development De lenergie Geothermique (Djiboutian Office of Geothermal Energy Development) (ODDEG). KenGen is also prospecting for similar businesses in Rwanda.
Kenya is Africa’s largest geothermal energy producer and among the top 10 in the world. The country has an estimated potential of 10,000MW along the Rift Valley.
